Great West Quarter Cladding Remediation Project

Overview

As a result of recent changes to applicable regulations, improvements are required to the façades of most buildings at Great West Quarter. As such Jessella Ltd (Building Envelope Specialist) has been appointed as the main contractor for the works, Stanmore Ltd has been appointed also been appointed as contractor . Jessella and Stanmore have individual contracts with the landlords of Great West Quarter, namely; Barratt London, A2Dominion and Notting Hill Genesis.

All parties appreciate that the work will involve a certain amount of inconvenience and disruption for residents, for which we are sorry. We will try our best to reduce the amount disruption that the works will cause.  These works will bring the buildings in Great West Quarter up to the latest fire safety standards.

The main elements to the remediation project at Great West Quarter are;

  • Replacing all cladding with a similar looking non-combustible material
  • Creating new fire breaks around windows and at floor level
  • Removing ground floor cladding, installing new fire breaks and installing new cladding
  • Removing brown coloured brick slips, installing new fire breaks and brick slips
Sequence

All scaffolding will be alarmed for your peace of mind. Alongside this, Great West Quarter has security, who regularly patrol the area and will be doing scaffold checks to ensure no unauthorised persons climb the scaffolding. This project is due to be completed in Summer 2022.

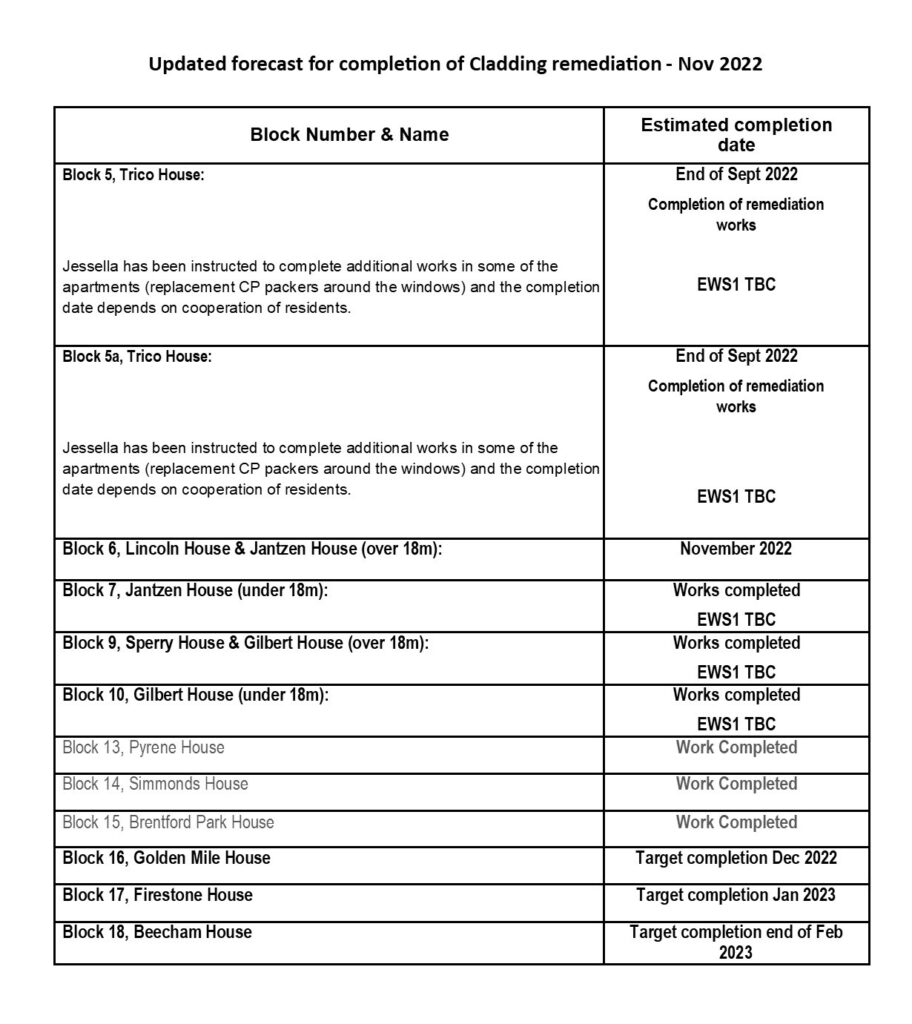

The table below outlines the start and end dates for each building. Please note, these dates are subject to change.

The teams working on the cladding remediation in Great West Quarter are;

  • Barratt London – Freeholder and landlord
  • A2Dominion – Landlord
  • Notting Hill Genesis – Landlord
  • Jessella Ltd – Contractor (blocks 5, 6, 7, 9, 10, 16, 17, 18)
  • Stanmore Ltd – Contractor (blocks 13, 14, 15)
  • NewmanFrancis Ltd – Resident liaison service

Please note: Works will not be progressing over the Christmas Period from 24th December 2020 to 3rd January 2021. Jessella’s last working day will be Wednesday 23rd December and will return to work on Monday 4th January. Stanmore’s last working day will be Tuesday 22nd December and will return to work on Monday 4th January.

About NewmanFrancis

NewmanFrancis Ltd has been appointed as the resident liaison team for the cladding remediation project at Great West Quarter. Our main roles are;

  • Keeping residents well informed about the works that are taking place and
  • Responding to any enquiries about the works from residents and stakeholders

We will use a variety of ways to deliver our services. These include individual letters, notices, posters, phone calls, social media, newsletters, events and regular updating of this webpage. We will be talking to residents to find out which of these methods you prefer.

Residents are asked to direct all enquiries regarding the works to NewmanFrancis and not the contractors’ operatives who will not be able to respond. NewmanFrancis will be working in partnership with all parties to ensure we have the most up to date information regarding the project.

You can contact us on 07541 916254 or 0800 644 6040 (freephone) or email gwq@newmanfrancis.org.

Frequently Asked Questions (FAQs)

In this section you will find answers to the most commonly asked questions about this project. If you don’t find an answer here, then please contact NewmanFrancis. We will update the FAQs on a periodic basis.

Frequently Asked Questions
Everything you need to know about the new ESW1 forms
External Wall Fire Review Process

Get in touch

You can contact us on 07541 916254 or 0800 644 6040 (freephone) or email gwq@newmanfrancis.org.

Alternatively, you can complete the contact form below:
